Estimated Construction Completion: February 2025
Estimated Settlement: March 2025

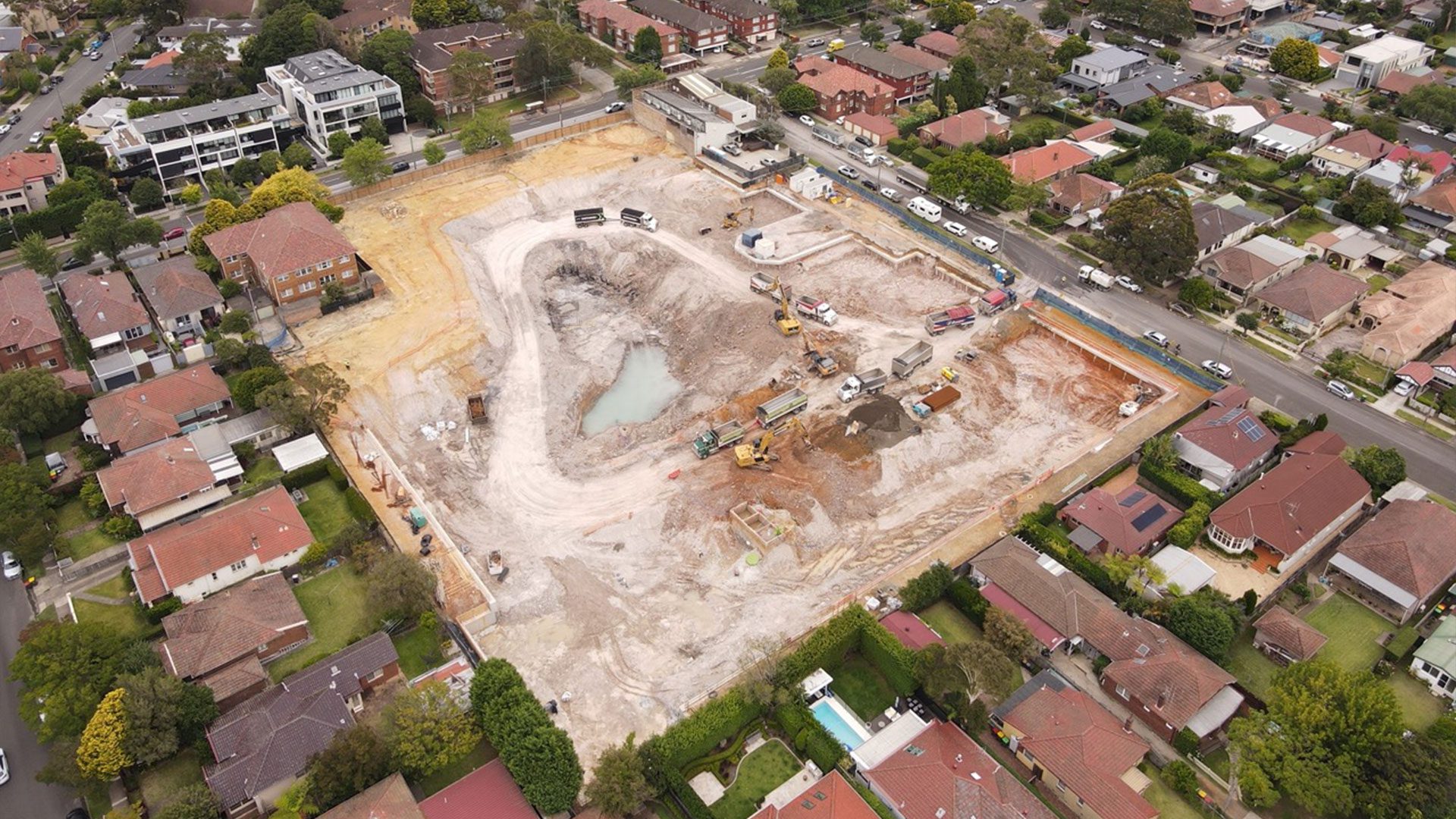

We wish to advise that building work continues to progress well.
Click here to view Hyegrove Willoughby construction timeline and 360-degree views.
Please see the construction update for the past quarter below:
Milestones:
- 150 Piles have been installed
- 50% of the capping beam installed
- Approx. 30,000 m³ of material removed off site
- Installation of concreting and anchors have commenced
Works planned on site for the first quarter of 2023:
- Completion of all piling
- Completion of form, reo & pour of the capping beams
- Completion of Bulk Excavation
- Completion Shoring (shotcreting & anchors)
- Commencement of detail excavation
- Commencement of Form, reo and pour of footings under the bottom basement slab
- Completion of sewer redirection works onsite
- Commencement of inground services
- Erection of Crane 1 of 2
Programme
The key programme items are as follows:
- Site set up works – Completed
- Demolition – Completed
- Shoring Works – In Progress
- Bulk Earthworks – In Progress
- Detailed Excavation – Not Started
- Basement works – Not Started
- Structure works – Not Started
- Services rough in – Not Started
- Window glazing – Not Started
- Facade cladding – Not Started
- Internal fit out works – Not Started
- Club Works – Not Started
- Finishing works – Not Started
- Landscaping – Not started
- Title registration – Not started
- Ready to settle –
