Construction Update – Hyegrove

Estimated Construction Completion: Early 2025
Estimated Settlement: Early 2025

Click here  to view a timeline of the build go to our 360 photo captured in January 2025

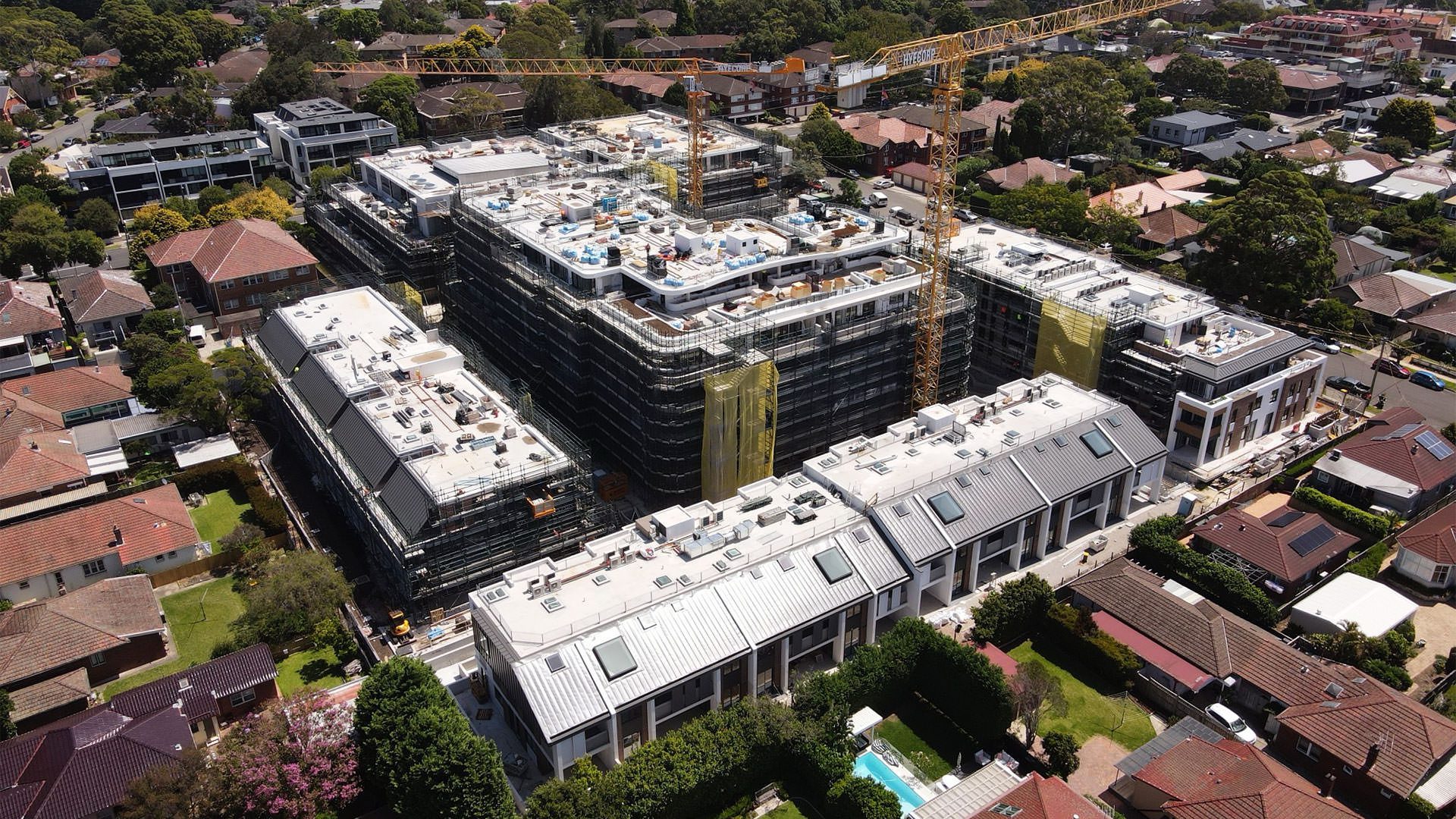

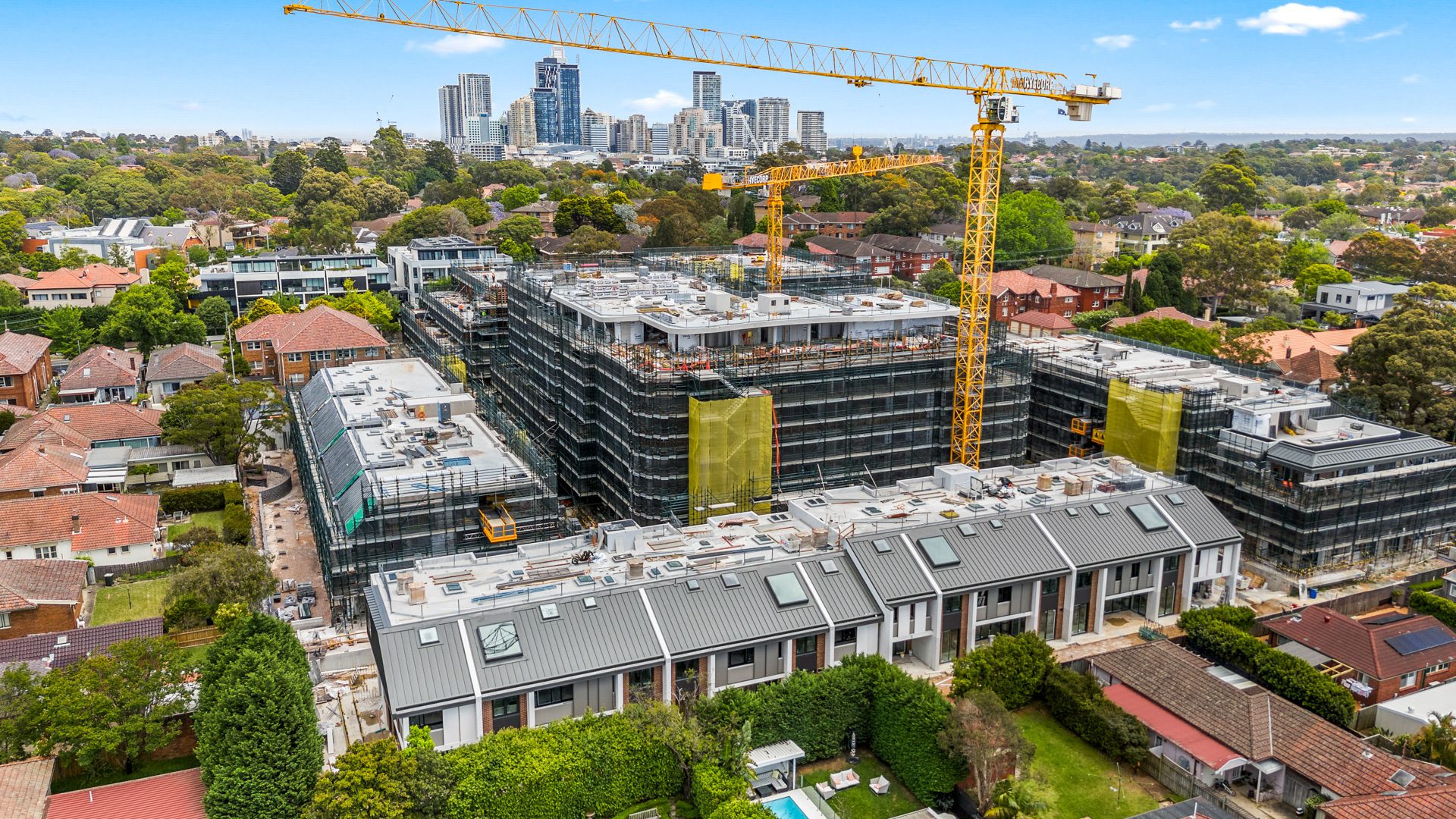

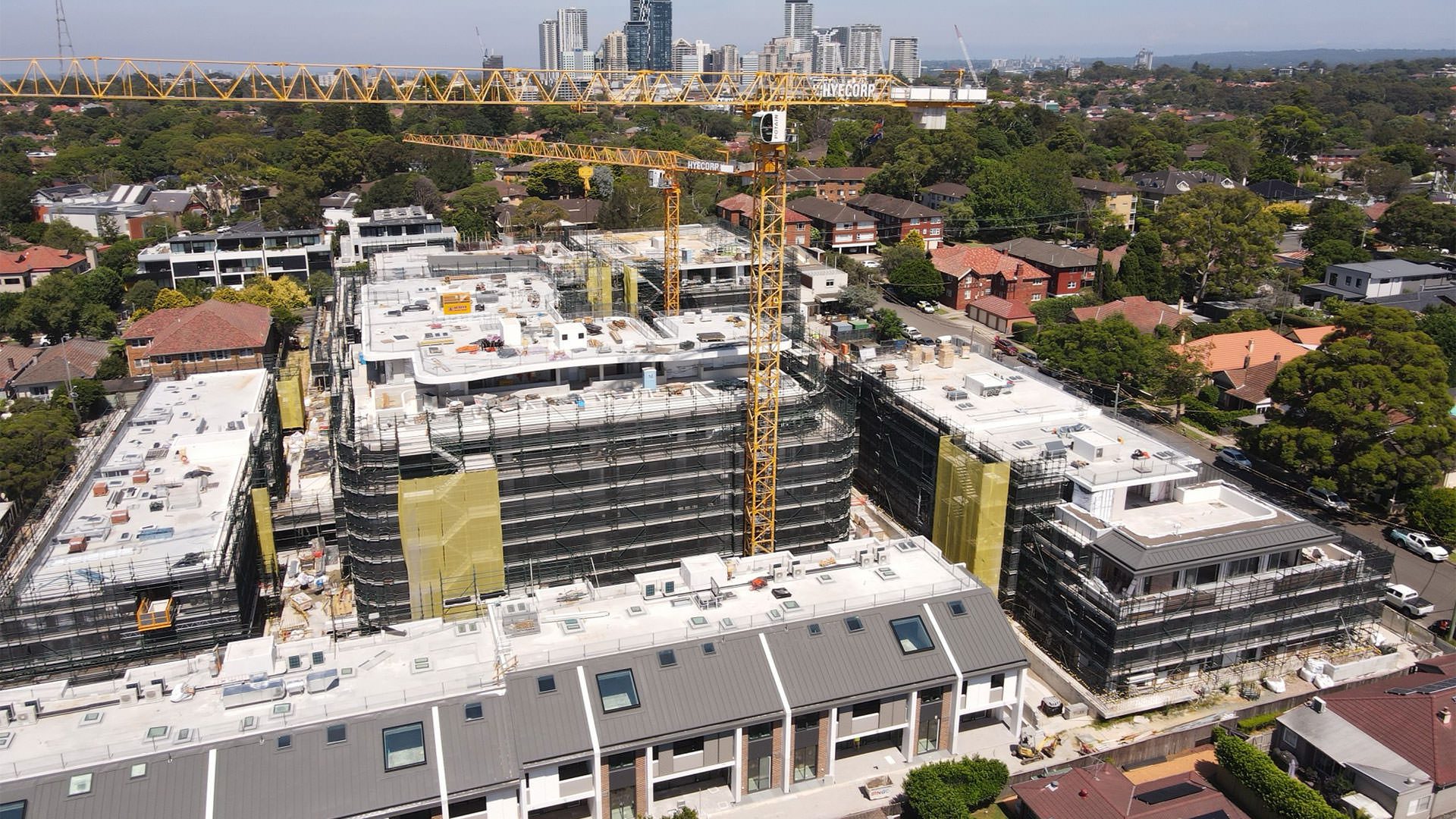

We wish to advise that building work continues to progress well.

Please see the construction update below:

Milestones:

September – December 2024:

  • Basement 03 – Cleaned with Storage Cage installation complete.
  • Basement 02 – High-Level Services rough-ins complete.
  • Basement 01 – Services Rough-in Complete.
  • Building C – final fit off and lock-up to Units.
  • Building B – final fit off and lock-up to Units up to Level 2.
  • Building D – above ceiling services rough-ins, internal walls sheeted, and bathroom fit off commenced.

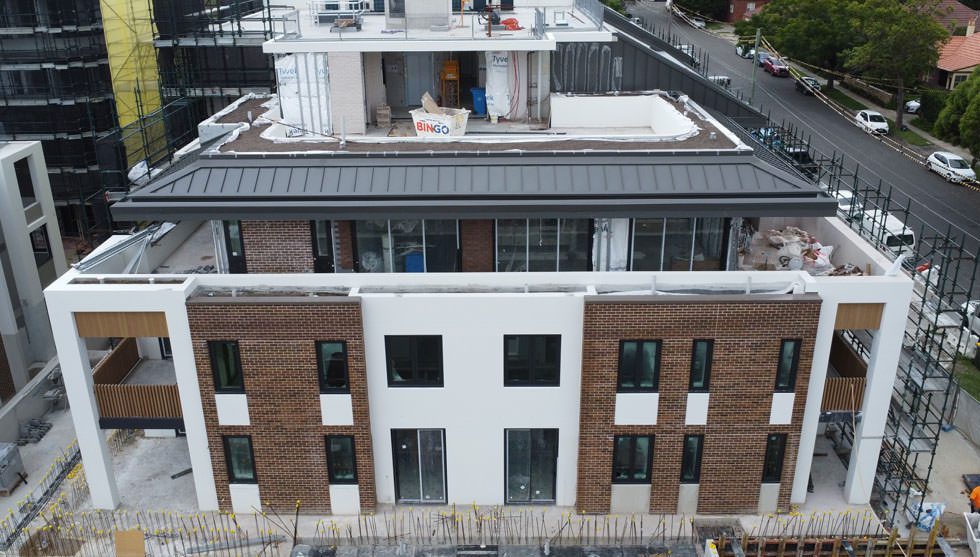

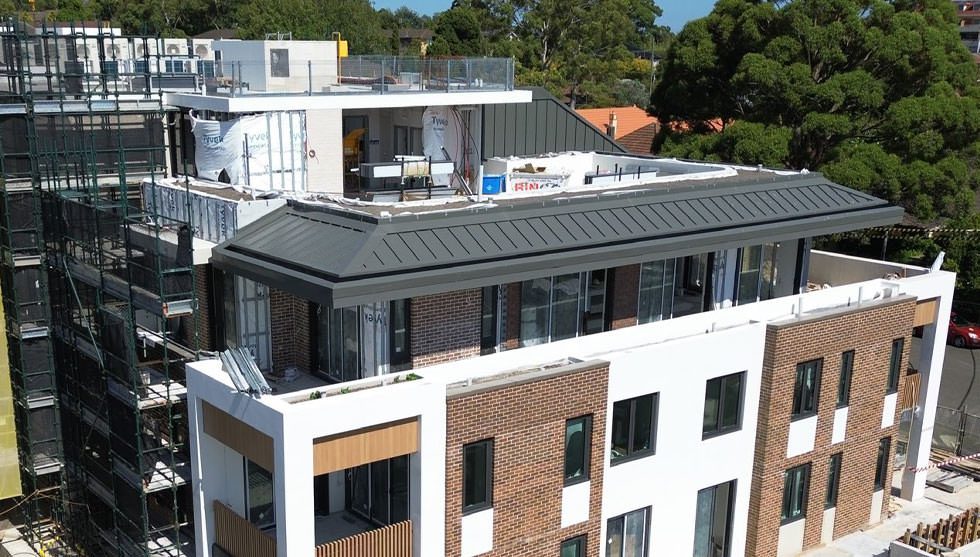

  • Building A – internal wall sheeting, windows, waterproofing, tiling and joinery installation complete up to Level 5.
  • Building E – internal wall sheeting, windows up to Level 4. Waterproofing and Tiling to Level 2.
  • Building F (Club Willougby) – Structure Complete, above ceiling services rough-ins, internal and external wall framing, waterproofing, and window prep to up to Level 2.
  • Façade & Scaffold Stripping to Buildings B & Commenced on A.
  • Building A Common Areas Level 1 & Level 2 – Internal framing and sheeting commenced to walls and ceiling.

Works planned on site for the next quarter of 2025:

January – March 2025:

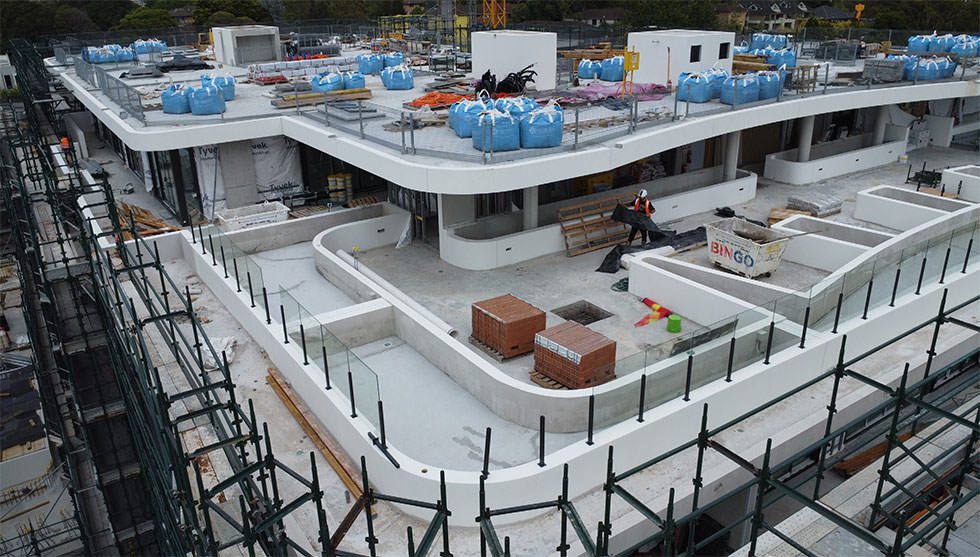

  • Basement 01 – Blockwork wall construction complete.
  • Basement 02 – High-Level Services rough-ins complete.
  • Basement 01 – Soffits & Columns painting complete.
  • Basement 01 – Soffit Insulation Complete.
  • Building C – final fit off and lock-up to Units.
  • Building B – final fit off and lock-up to Units up to Level 3.
  • Building D – above ceiling services rough-ins, internal and external wall framing, waterproofing, and window prep complete.
  • Building A – internal wall sheeting, windows, waterproofing, tiling and joinery installation complete up to Level 4.
  • Building E – above ceiling services rough-ins, internal and external wall framing and window prep complete.
  • Building F (Club Willougby) – Structure Complete, above ceiling services rough-ins, internal and external wall framing, waterproofing, and window prep to commence up to Level 2.
  • Façade & Scaffold Stripping to Buildings B & D.

Programme

The key programme items are as follows:

  • Site set-up works Completed
  • Demolition Completed
  • Shoring Works Completed
  • Bulk Earthworks Completed
  • Detailed Excavation Completed
  • Basement works In Progress
  • Structure works Completed
  • Services rough in In Progress
  • Window glazing In Progress
  • Facade framing & cladding In Progress
  • Internal fit-out works In Progress
  • Club Works In Progress
  • Finishing works In Progress
  • Landscaping In Progress
  • Title registration In Progress
  • Ready to settle –

Next Update: April 2025
